1. Executive Summary
Decision Requested
Issue written determination denying Protest 014 and all four relief requests.
- Recommendation: Deny — ATC-1 text is explicit and self-contained
- Cost Exposure: $1,406,243 (AECOM $1,071,847 + Skanska $334,396)
- Risk Level: Moderate — strengthened by verified source documents (RFIs, RCSR, workshop notes)
Core Question
Does ATC-1 require structural continuity (combined spread footings + pier walls) for the NB405 Bridge 405-103E widening, or did it only replace drilled shafts with spread footings?
ATC-1, titled “228th St Foundation Optimization,” replaced drilled shaft foundations with spread footings at three structures including Bridge 405/103E. Skanska argues the ATC was limited to a foundation swap. WSDOT’s position is that ATC-1 Items 3, 4, and 6 read together describe a unified structural system — combined spread footings and pier walls — that must be replicated for the widening. See Internal Memo Pillar 2 for the full read-together analysis.
ATC-1 Item 3 states that “spread footings will be combined” at the intermediate piers, with “the final design of combining the spread footing and the existing drilled shaft” to be “determined during final design.” Item 6 states the pier diaphragm and pier cap “will be widened to match the existing structure.” WSDOT reads these provisions together with Item 4 (pier wall per Figure 2) as establishing structural continuity. Skanska reads “match” as dimensional compatibility only. See Internal Memo Pillar 2 for the full read-together analysis.
The protest was filed February 20, 2026 (Skanska LTR 356). WSDOT acknowledged the protest and denied the extension request (WSDOT SL 277, Feb 23). The supplemental was received March 6, 2026 (Skanska LTR 370) with AECOM’s 11-page technical narrative and a $1,406,243 cost claim. Written determination due ~March 27, 2026.
2. Skanska Assertions and WSDOT Position
Full analysis in the Position Map and Internal Memo (open in viewer panel).
| ID | Assertion | WSDOT Position | Strength | Reference |
|---|---|---|---|---|
| A | ATC-1 scope limited to foundation swap; title says “Foundation Optimization” | Items 3, 4, 6 describe unified structural system; DB Proposal treats widening as given ATC component | Strong | Internal Memo Pillar 1; Position Map LTR356-2a |
| B | “Match” (Item 6) means dimensional compatibility only | Item 6 “match” + Item 3 “combining” read together require structural integration; dimensional-only renders Item 3 surplusage | Strong | Internal Memo Pillar 2; Position Map LTR356-2b |
| C | ATC-8 precedent — WSDOT treated ATC figures as non-definitive | Different domain (roadway geometry vs. structural text); ATC-1 position rests on Items 3, 4, 6 text | Moderate | Internal Memo Pillar 3; Position Map LTR356-2e |
| D | Two-year silence (Apr 2023 – Nov 2025) implies no requirement | No widening submittal during gap; GP 1-04.4(5)(n) assigns ATC costs regardless of timing | Moderate | Internal Memo Pillar 4; Position Map LTR356-2d |
| E | WSDOT has not provided sufficient technical direction | Direction via SL 201, SL 237, SL 262; ATC-1 Items 3+4 are the technical direction | Strong | Position Map LTR356-2a–2e |
Supplemental Assertions (LTR 370, March 6, 2026)
| ID | Assertion | WSDOT Position | Strength | Reference |
|---|---|---|---|---|
| F | Comment #9 closure (Nov 2024) = acceptance of separate substructure | RCSR shows reviewer questioned omission; GP 1-03.7: closing Q&A ≠ endorsement. No DBIC filed | Strong | Internal Memo Pillar 5; Position Map LTR370-2a |
| G | Changed geotechnical conditions invalidate deep footing rationale | Contract text unchanged by conditions; obligation unconditional. Proper path: DBIC | Strong | Internal Memo Pillar 6; Position Map LTR370-2b |
| H | BDM 15.2.10 code compliance concerns (in-ground plastic hinges) | Design challenge, not contract interpretation. DB accepted obligation per GP 1-04.4(5)(n) | Strong | Internal Memo Pillar 7; Position Map LTR370-2c |
| I | Closure pour requires two traffic phases, impacts 228th Ave | Implementation challenge; foreseeable when DB proposed ATC for bridge over live roadway | Strong | Internal Memo Pillar 7; Position Map LTR370-2d |
| J | Industry practice (Caltrans MTD 9-3, Talbot Road) supports separate substructures | External standards don’t override project-specific contract language | Strong | Internal Memo Pillar 8; Position Map LTR370-2e |
| K | 11 months of good-faith design reliance (Nov 2024 – Oct 2025) | DB had contract text throughout; RFI 461 proves DB knew approach was disputed | Strong | Internal Memo Pillar 5; Position Map LTR370-2f |
| L | Cost claim: $1,406,243 (AECOM $1,071,847 + Skanska $334,396) | Not entitled; no change occurred. GP 1-04.4(5)(n): ATC costs are DB’s responsibility | Strong | Internal Memo Pillar 9; Position Map LTR370-4 |
| M | Schedule claim: +6 months design, +4 months RFC | Not entitled; no change. GP 1-04.4(5)(n) and (5)(m) | Strong | Internal Memo Pillar 9; Position Map LTR370-5 |
| N | Sonia Berriz statement shows internal WSDOT disagreement | Berriz concluded DB’s design does NOT meet contract requirements — aligns with WSDOT position | Strong | Internal Memo rebuttal; Position Map |
3. Risk
Strengths
- ATC-1 text is explicit and self-contained — Item 3 uses “combined”/“combining” and Item 6 uses “match,” both structural-continuity terms
- Three consistent written positions — SL 201, SL 237, SL 262 — anchored to specific ATC language
- GP 1-04.4(5)(n): ATC implementation costs are DB’s exclusive responsibility
- Skanska’s own DB Proposal describes ATC-1 as treating the widening as a given component
- ATC-1 approval was unconditional — “The ATC is approved” with no carve-outs
- RFI 461/461.1 confirm WSDOT consistency after March 2025 — “not what the ATC was based on or approved”
- WSDOT showed flexibility on HOW (Nov 13 meeting: Pang suggested alternatives to avoid closure pour impacts)
- RFI 461 undermines reliance argument — if Comment #9 was acceptance, why submit an RFI?
- DB never submitted a DBIC despite being directed to multiple times (RFI 461, RFI 461.1, Workshop)
- Pang did not close Comment #9 — structures reviewer was not the person who closed the comment
- AECOM’s language escalates from “closed the comment” (p.2) to “confirmed acceptance” (p.7) within same document
- Type Selection Workshop: “ATC is the baseline TODAY” — WSDOT accepted 3 of 8 options
- Pat’s admission: “thought they would be ok” — DB assumed WSDOT would be flexible, not that ATC contemplated flexibility
Potential Weaknesses
- Comment #9 closure creates narrative vulnerability — but mitigated by verified RCSR text (questions omission, not neutral inquiry)
- Two-year gap now includes 4-month design reliance period (Nov 2024–Mar 2025)
- WSDOT’s initial use of “Forward Compatibility” (a non-contract term) was imprecise; corrected in SL 237 but Skanska may frame the correction as a shift
- “Match” (Item 6) is genuinely ambiguous in isolation — WSDOT’s reading requires Item 3 context (“combining”)
- DRBs tend toward compromise; panel may split the difference on scope
Pre-empted Counter-Arguments
| ID | Counter-Argument | WSDOT Rebuttal |
|---|---|---|
| CA-1 | “Forward Compatibility” withdrawal = position change | SL 237 corrected terminology, not substance. The requirement (ATC-1 Items 3+4) remained unchanged throughout. Using a non-contract label was imprecise; abandoning the label is not abandoning the requirement. |
| CA-2 | ATC approval was unconditional — no continuity condition | The ATC text itself contains the requirement. Approval confirms the text as contract standard. Items 3+4 are self-executing — no separate condition was needed. |
| CA-3 | Industry practice: “match” = dimensional | Contract-specific language controls over general industry usage. Item 3’s “combining” removes ambiguity. Reading “match” as dimensional-only renders Item 3 surplusage. |
| CA-4 | Cost burden is disproportionate | Proportionality does not override explicit contract language. GP 1-04.4(5)(n) assigns ATC implementation costs to DB regardless of magnitude. |
Gaps in Skanska’s Submittal
- No analysis of the word “combining” in Item 3 — Skanska’s argument depends on reading Item 3 in isolation

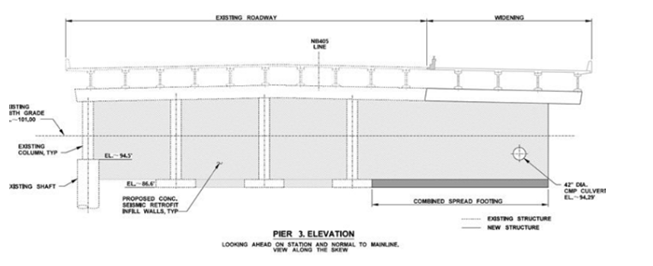

- Selective reading of ATC-1: focuses on title and Item 3, ignores Items 4 and 6
- No analysis of GP 1-04.4(5)(n) (ATC cost responsibility)
- Conflation of WSDOT’s terminology correction (“Forward Compatibility”) with a substantive position withdrawal
- RFI 461 undermines reliance argument — DB sought confirmation after “acceptance,” proving they knew it was disputed
- Pat’s admission (“thought they would be ok”) undercuts the ATC flexibility argument — DB assumed WSDOT would accept changes, not that ATC permitted them
- DBIC presentation title is itself an admission — DB framed its own alternative approach as a DBIC, not a contract-compliant design
4. Chronology
| Date | Event |
|---|---|
| 2023-04-03 | ATC-1 approved — “The ATC is approved.” Unconditional. ATC-1 |
| 2024-05-01 | Preliminary design submitted — SUB 17.01 (Comment #9 origin) |
| 2024-11-19 | Comment #9 closed — reviewer questions missing closure pour. RCSR |
| 2025-01-29 | WSDOT issues ATC-8/17th Ave interpretation — later cited by Skanska as precedent |
| 2025-03-05 | Pang raises compliance concern at Structures Task Force — AECOM frames as “reversal” |
| 2025-03-10 | DBIC presentation — AECOM presents alternatives to Skanska/WSDOT. 103E Notes |
| 2025-03-19 | Pang/Mohammad: “HAVE TO CONNECT” — structural basis for connection requirement. 103E Notes |
| 2025-05-09 | Boris Sizivu: “I do believe the Contract requires you to take a different approach.” 103E Notes |
| 2025-06-18 | RFI 461 — AECOM requests confirmation of separate substructure approach |
| 2025-06-25 | RFI 461 response — DBIC required; “not what the ATC was based on or approved” |
| 2025-07-08 | RFI 461.1 — AECOM asks WSDOT to cite specific contract sections |
| 2025-07-18 | RFI 461.1 response — GP 1-03.2 clause 3 cited; ATC-1 Page 3 lines 9 and 23 |
| 2025-10-09 | Pre-workshop: Pat admits “thought they would be ok.” 103E Notes |
| 2025-10-22 | Type Selection Workshop — “ATC is baseline TODAY”; WSDOT accepts Options 1, 2, 4 |
| 2025-11-13 | RCSR meeting — Pang suggests alternatives (flexibility on HOW, not WHETHER) |
| 2025-11-21 | WSDOT SL 201 — identifies structural continuity requirement for Bridge 405/103E widening |
| 2025-12-05 | Skanska LTR 288 — disputes structural continuity requirement |
| 2026-01-13 | WSDOT SL 237 — corrects “Forward Compatibility” terminology, reaffirms ATC-1 continuity requirement |
| 2026-01-27 | Skanska LTR 333 — argues “match” is dimensional only, cites ATC-8 precedent |
| 2026-02-06 | WSDOT SL 262 — formal determination; treats ATC-1 as contract standard requiring structural continuity |
| 2026-02-20 | Skanska LTR 356 — Notice of Protest 014; five bases + 14-day extension request |
| 2026-02-23 | WSDOT SL 277 — acknowledges protest, denies extension, supplemental due March 6 |
| 2026-03-06 | Supplemental received — LTR 370 ($1,406,243 claim) |
| ~2026-03-27 | Written determination due (21 calendar days after supplemental per GP 1-04.5) |
5. Cost & Time
Cost Breakdown (from LTR 370)
| Component | Amount |
|---|---|
| AECOM Design (4,119 hrs: General/Mgmt 229, Bridges/Structures 3,476, MOT 387, DQM 27) | $1,071,847 |
| Skanska Construction (closure pour base $267,517 + 25% markup) | $334,396 |
| Total | $1,406,243 |
Schedule Impact
+6 months final design, +4 months RFC. Formal delay analysis pending from AECOM. Preliminary estimate contingent on WSDOT comment turnaround.
Relief Requests and Disposition
| # | Relief Requested | WSDOT Disposition |
|---|---|---|
| 1 | Withdraw the structural continuity interpretation of ATC-1 | Denied — ATC-1 text is explicit |
| 2 | Compensable change order for widening redesign | Denied — GP 1-04.4(5)(n): ATC costs are DB’s |
| 3 | Schedule extension for redesign duration | Denied — GP 1-04.4(5)(n) and (5)(m) |
| 4 | 14-day extension for supplemental submission | Denied — per SL 277; standard 14 days applies |
| 5 | Cost adjustment: $1,406,243 | Denied — No change occurred; GP 1-04.4(5)(n) |
| 6 | Schedule adjustment: +6mo design / +4mo RFC | Denied — No change occurred; GP 1-04.4(5)(m) and (n) |
Next steps: Issue written determination within 21 calendar days (~March 27) per GP 1-04.5, denying the protest. If Skanska escalates to DRB, the Comment #9 narrative and two-year gap will need proactive framing. WSDOT’s verified source documents (RCSR, RFIs, workshop notes) significantly strengthen the defense.
6. Open Items — Case Development Tracker
Outstanding work items for DRB preparation. Items sourced from initial analysis and Internal Memo path forward.
| # | Item | Priority | Status | Notes |
|---|---|---|---|---|
| 1 | ATC-8 / 17th Ave correspondence (Jan 29, 2025) — locate the email where WSDOT stated figure “did not apply” | High | OPEN | Needed to rebut ATC-8 consistency argument (Card C) |
| 2 | GP 1-03.1 precedence: ATC-1 applies to Proposal (level 7) or TR (level 5)? | Medium | OPEN | Moot if Clause 3 applies; resolve for completeness |
| 3 | Assemble DRB position paper (nine pillars) | High | NOT STARTED | Primary DRB deliverable |
| 4 | Prepare witness outlines (Berriz, Sizivu, Bondy, Pang) | High | NOT STARTED | Key witnesses for hearing preparation |
| 5 | Compile full Comment #9 history with original records | High | NOT STARTED | Email exchange containing DB response and closure action |
| 6 | Prepare read-together exhibit (ATC-1 Items 3, 4, 6 + Figure 2 side by side) | Medium | NOT STARTED | Visual aid for DRB presentation |
